Building on the Water on Cape Cod: What to Plan For

Featured image for the O'Neill Bowes Building article on Waterfront Building
Waterfront construction on Cape Cod is not a premium version of building inland. The regulatory environment activates more extensively, the soils require more diagnostic work, and the material specifications are more demanding. Almost all of the complexity lives in preconstruction — before a shovel breaks ground.

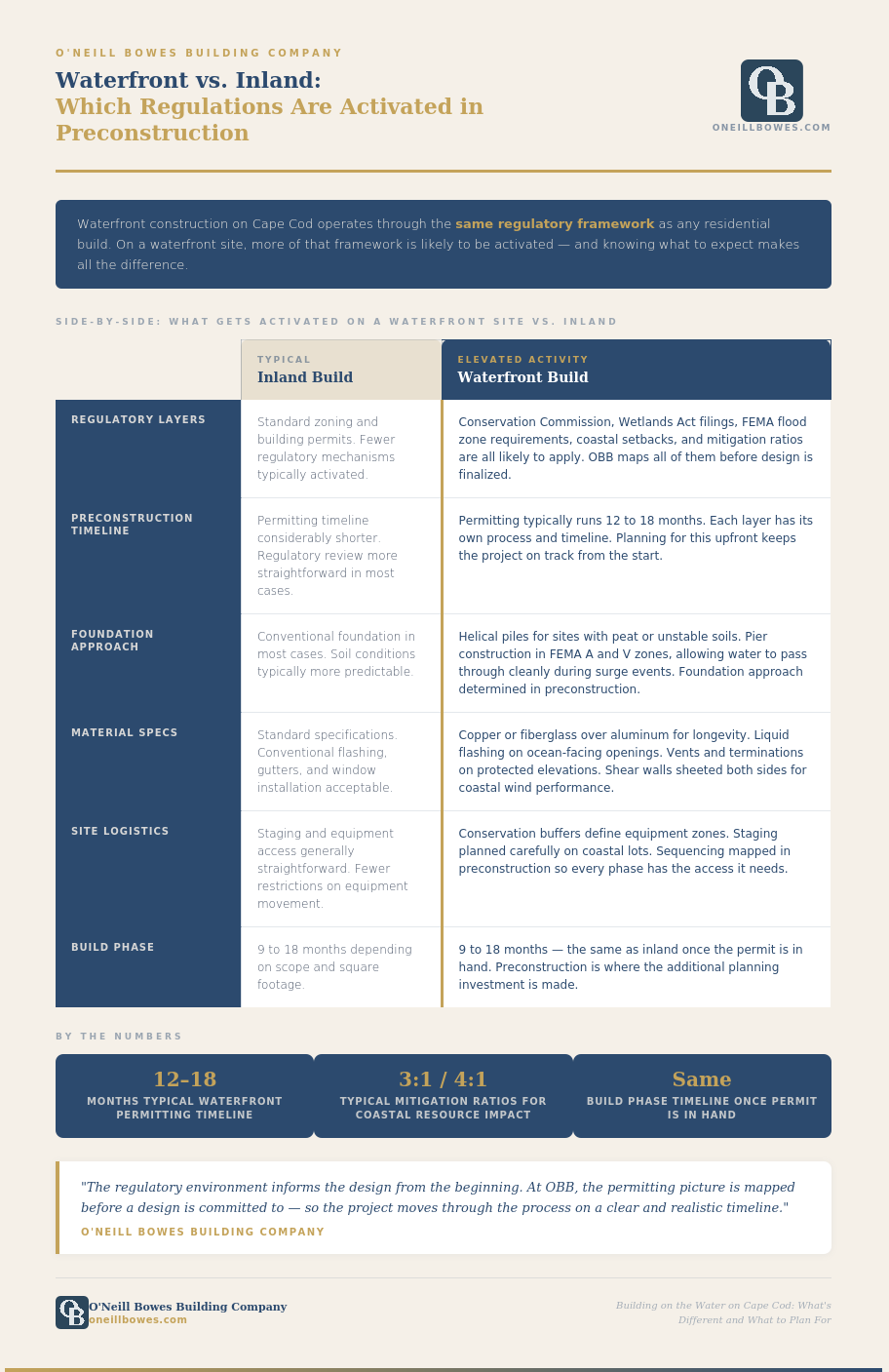

Article Summary

What makes waterfront construction on Cape Cod different from building inland?
The permitting process operates through the same regulatory framework as any residential build, but on a waterfront site significantly more of that framework gets activated simultaneously. Conservation Commission review, Wetlands Protection Act filings, FEMA flood zone requirements, coastal setbacks, and mitigation ratios all apply more extensively, each with its own timeline and conditions. The build itself, once permitted, runs comparably to any custom home of similar scope.
How long does a waterfront construction project take on Cape Cod?
The build phase runs nine to eighteen months regardless of square footage, comparable to any custom home. What precedes it is harder to predict. Preconstruction and permitting on a waterfront project can take considerably longer than clients who have built inland might expect, as conservation filings, wetlands reviews, and town-specific permitting processes run on their own schedules rather than the builder's.
What foundation approaches are used for waterfront construction on Cape Cod?
Foundation decisions on waterfront sites are shaped by soil conditions and FEMA flood zone designations. Unstable soils like peat require helical piles driven to refusal rather than conventional foundations. In FEMA A and V zones, where wave action and surge are planning factors, pier construction may be required so that water passes beneath the structure during a surge event rather than building shear force against a solid foundation.
What materials does O'Neill Bowes specify differently for waterfront projects?
Aluminum gutters, drip edge, and flashing are avoided on coastal sites due to accelerated corrosion from salt air. Copper or lead-coated copper is recommended for those applications, with fiberglass gutters as an alternative. Windows and doors on ocean-facing walls are set with liquid flashing into a liquid adhesive barrier. Vents and mechanical terminations are located away from ocean-facing exposures. Walls facing wind and water load are sheeted on both sides for rigidity, with additional hold-downs and Simpson ties specified to meet wind zone requirements.
How does OBB handle the logistics of building on a tight waterfront lot?
Site access and sequencing are mapped in preconstruction before anyone sets foot on the site. On one recent project, the pool had to be installed early in the schedule because once the structure was up there would be no viable equipment access to the backyard. The team built their way out, sequencing each phase to preserve staging area for concrete trucks and equipment. Conservation buffers, neighbor proximity, and access routes that change with weather conditions are all factored into the phased schedule before construction begins.

Introduction

Preparing to build on the Cape Cod waterfront is a different category of pre-construction than prepping to build inland, and the gap between the two is wider than many clients could expect, particularly if they’ve either only built inland or have never built a home before at all.

The regulatory environment is far more layered, the soil conditions are less predictable, the material specifications more specific, and the timeline harder to control from the front end. Many of the factors determining whether a waterfront project will go smoothly are almost all made before a shovel breaks ground, in preconstruction. That’s where the complexity lives.

What follows is an honest overview of what waterfront construction on Cape Cod actually involves: what makes it different, where the pressure points are, and what clients who are thinking about building or rebuilding on the water should be expecting going into the first conversation.

The Regulatory Layer Required Substantial Attention

The permitting process for a waterfront project on Cape Cod operates through the same regulatory framework as any other residential build. The difference is how much of that framework gets activated and put into play.

Conservation Commission review, Wetlands Protection Act filings, FEMA flood zone requirements, coastal setbacks, mitigation ratios … these mechanisms exist for inland projects too. On a waterfront site, more of them apply, they apply more extensively, simultaneously. A project that triggers one or two of these inland might trigger all of them on the water, each with its own timeline, its own conditions, and its own opportunity for the unexpected.

That's what extends the front end of a waterfront project. Not a different process, but so much more of the same process running in parallel. Having the right civil engineer and surveyor engaged early, understanding each town's specific setback requirements and mitigation ratios, and knowing how to work effectively with conservation commissions are what determine whether a project moves through that process efficiently or gets held up in it.

At OBB, the regulatory picture gets mapped before the design is finalized. There is no value in developing a site plan that will require significant revision once the conservation filing is reviewed. The regulatory environment informs the design from the beginning, which is the only approach that keeps the project on a realistic timeline.

The preconstruction & permitting phase on a waterfront project can take considerably longer than clients who have built inland might expect. That timeline is worth understanding going in, because it shapes the schedule of everything that follows.

Soils, Foundations, and What's Under the Ground

Coastal soils on Cape Cod are not uniform and they’re not always what they appear to be from the surface. Peat deposits, man-made fill, unstable bluff material, or high water tables are all common enough in waterfront settings that a geotechnical assessment is a standard practice in preconstruction rather than an optional practice. What's under the ground shapes every foundational decision that follows.

On one recent project in Mashpee, the site appeared straightforward until the ground was opened and peat was discovered beneath the surface. Peat is compressible and unstable as a bearing material, which meant a conventional foundation was off the table. The solution was helical piles: steel screws driven deep into the ground to refusal, then filled with concrete to create stable footings independent of the compromised soil above. It's a reliable approach when the conditions call for it, but it's also one that adds cost and time that a surface assessment alone could not have anticipated.

FEMA flood zone designations introduce another set of foundation requirements on waterfront sites. In A zones and V zones, where wave action and surge are planning factors, conventional foundations may not be permitted at all. Pier construction becomes the required approach, allowing water to pass beneath the structure during a surge event rather than building shear force against a solid foundation. The distinction between zone types determines which parameters apply, and those parameters are established in preconstruction before a foundation design is finalized.

What's under the ground on a waterfront site is a question that gets answered early at OBB, because what we discover could change everything that piles on afterward.

Materials That Actually Perform in a Coastal Environment

Salt air is corrosive in ways that don't always show up immediately but they certainly compound over time. The material decisions made during a waterfront build determine how a structure holds up, not just in year one but across decades of exposure to conditions that inland projects don’t face. At OBB, those decisions are made with longevity as the primary criterion, and the reasoning behind each one is explained to clients clearly because the cost difference is as real as the value of getting it right is essential.

Aluminum is the most common material to avoid. Gutters, drip edge, and flashing specified in aluminum on a coastal site will degrade faster than the same components inland. Copper or lead-coated copper is the recommendation in those applications. Fiberglass gutters perform well when copper isn't the preferred design. The difference in upfront cost is meaningful but so is the difference in lifespan.

Windows and doors on ocean-facing walls are installed to a higher standard, sometimes with liquid flashing used to set frames into a liquid adhesive barrier rather than relying on conventional sealing alone. Vents, hoods, and mechanical terminations are located away from ocean-facing exposures wherever possible, tucked into protected elevations to limit direct wind and water intrusion.

The same logic extends to the structure itself: Often times its designed to incorporate"Shear Walls" by the structural engineer or design team to brace the structures water facing facade from high winds, and this can be achieved by adding interior plywood on particular areas of the structure to reinforce the exteriors most impacted, or by using structural steel bracing or other reinformcents.  Often additional hold-downs and Simpson ties are specified to meet wind zone requirements. The structural and civil engineers write those specifications in and hand them back as part of the preconstruction package. The frame goes up the same way it does inland. What surrounds and secures it on a waterfront site is held to a standard the environment will eventually test.

Erosion, Bluff Stability, and Anticipatory Building for a Moving Shoreline

Cape Cod's shoreline is not static. In exposed locations, it can move several feet in a single storm event, and the cumulative loss across years and decades is a planning reality that any builder working near the water has to account for. A bluff that looks stable today may look meaningfully different in two years and unrecognizable in ten. The structure sitting on or near it needs to have been sited and designed with that in mind from the beginning.

At OBB, the topography of a waterfront lot is assessed in preconstruction with the civil engineer, whose read on the site's erosion exposure and long-term stability informs both the siting and the foundation approach before a design is committed to. Setbacks from coastal resources are established by regulation, but the engineering assessment often tells you more than the minimum setback does about where a structure actually belongs on a given lot. Often, OBB will manage the communication between what the civil engineer determines and what the architect is designing, making sure the two are working from the same understanding of the site's constraints.

During construction, erosion mitigation is active and ongoing. Silt fencing, hay bales, vehicle restrictions near embankments, and drainage management through gutters and dry wells are all standard practice on a coastal site. These aren't optional precautions. Conservation Commission approvals are conditioned on them, and weekly monitoring is part of staying in compliance through the build.

The goal is a structure that fits its site not just on the day it's finished but across the lifespan it was built for.

Site Access, Logistics, and the Construction Reality

Waterfront sites on Cape Cod are often logistically demanding to build on, and the constraints don't present themselves until you're already on the ground so it’s key to plan for them in advance.

One recent, very successful, project is a noteworthy example of what that planning actually requires. The lot was small relative to the size of the home being built, stretched out to the lot lines, with a pool specified in the scope. On a site with more room, the pool might be sequenced toward the end of the project. Here, it had to be installed early, because once the house structure was up there would be no viable way to get the equipment to the backyard for the inground. The team had to build their way out, sequencing the work so that each completed phase preserved access for what came next, keeping retaining walls at bay long enough to maintain a staging area for concrete trucks and equipment.

  • Conservation buffers limit where equipment can operate.
  • Neighbors on tight coastal lots are paying close attention.
  • Access routes that work in dry conditions may not work after a storm.

All of it gets mapped in preconstruction using phased scheduling tools that allow the team to see how sequencing decisions ripple forward through the project before anyone sets foot on the site.

What the Timeline Actually Looks Like

The honest answer is that preconstruction on a waterfront project doesn't have a reliable timeline, and that's the part clients can underestimate.

The build itself (framing, systems, finishes, everything that happens after the permit is in hand) runs on a timeline comparable to any custom home of similar scope. Nine to eighteen months is a reasonable range regardless of square footage. That part is plannable.

What precedes it is harder to predict. Conservation Commission review, wetlands filings, FEMA flood zone determinations, and town-specific permitting processes don't run on a builder's schedule. They run on their own schedule. A filing that moves smoothly through one town might sit considerably longer in another. Conditions are added and revisions requested. The process takes the time it takes with that many moving parts.

At OBB, preconstruction is treated as its own phase with its own disciplines, not as a waiting period before the real work begins. Clients who understand that going in are better positioned to make good decisions throughout.

Building on the Water

Waterfront construction on Cape Cod is not a premium version of building inland. It is a category of work that requires more preparation, more regulatory navigation, more material precision, and more logistical planning than many clients anticipate when they first start thinking about it.

The builders who do it well are the ones who treat preconstruction as seriously as construction, who know the regulatory landscape well enough to design around it from the beginning, and who have built enough waterfront projects to know where the surprises tend to come from before they arrive.

At O'Neill Bowes, that experience is built into every waterfront project from the first conversation forward.

•••••

Planning a project on Cape Cod?
Call our office anytime to discuss: 508-419-2622

Key Points

What makes waterfront construction on Cape Cod categorically different from building inland?

Waterfront construction on Cape Cod is not a premium version of standard residential construction. It requires a different level of preparation, regulatory navigation, and material precision across every phase of the project.

  • The regulatory framework is the same as any residential build, but on a waterfront site significantly more of it gets activated simultaneously, with Conservation Commission review, Wetlands Protection Act filings, FEMA flood zone requirements, and mitigation ratios all potentially in play at once
  • Soil conditions are less predictable on coastal sites, with peat deposits, man-made fill, unstable bluff material, and high water tables all common enough that geotechnical assessment is standard preconstruction practice rather than optional
  • Material specifications are more demanding because salt air, UV exposure, coastal humidity, and storm-driven moisture place sustained demands on building components that inland projects never face
  • Site logistics are more constrained, with conservation buffers limiting equipment movement, tight lot coverage leaving little staging room, and access routes that change with weather conditions
  • Almost all of the complexity is front-loaded in preconstruction, before a permit is filed and before a shovel breaks ground, which is where the decisions that determine project outcomes are actually made

How does the regulatory permitting process work for waterfront construction on Cape Cod?

The permitting process for a waterfront project operates through the same regulatory framework as any residential build. The difference is how many of those regulations get activated and how extensively they apply.

  • Conservation Commission review governs setbacks from coastal resources, mitigation requirements, and the conditions under which work near the water can proceed, and carries the most weight on waterfront projects
  • Wetlands Protection Act filings' run alongside or through the Conservation Commission process depending on the town, adding their own timeline and review requirements
  • FEMA flood zone designations determine what kind of foundation is permissible, what floor elevation is required, and what insurance requirements the structure carries for its lifetime
  • Mitigation ratios, typically 3:1 or 4:1, apply when coastal resources are impacted and require compensatory work as a condition of approval
  • At OBB, the regulatory picture is mapped before the design is finalized, because developing a site plan that requires significant revision after a conservation filing is reviewed adds time and cost that serves no one

What foundation and soil considerations apply to waterfront construction on Cape Cod?

Coastal soils on Cape Cod are not uniform, and what's beneath the surface on a waterfront site is not always apparent until the ground is opened. Foundation decisions follow from what the soil and flood zone designations actually require.

  • Peat is a common discovery on coastal sites, compressible and unstable as a bearing material, requiring helical piles driven deep to refusal and filled with concrete rather than conventional foundation construction
  • Man-made fill and unstable bluff material present similar challenges and are common enough on waterfront lots that geotechnical assessment is treated as a standard preconstruction step at OBB
  • FEMA A zones and V zones introduce specific foundation requirements based on wave action and surge patterns, with pier construction required in many cases so that water passes beneath the structure rather than building shear force against a solid foundation
  • The distinction between zone types determines which parameters apply, and those parameters are established in preconstruction before a foundation design is finalized or a structural engineer begins their work
  • What's under the ground shapes every decision above it, which is why the geotechnical picture is established early and why foundation design at OBB follows the site conditions rather than preceding them

What material specifications does O'Neill Bowes require for waterfront projects that differ from inland builds?

Salt air is corrosive in ways that compound steadily over time. The material decisions made during a waterfront build determine how a structure performs not just in year one but across decades of coastal exposure.

  • Aluminum is avoided' for gutters, drip edge, and flashing on coastal sites, replaced with copper, lead-coated copper, or fiberglass alternatives that resist salt air corrosion over the long term
  • Windows and doors on ocean-facing walls are set with liquid flashing into a liquid adhesive barrier rather than conventional sealing, providing a higher standard of moisture protection at the most exposed openings
  • Vents, hoods, and mechanical terminations are located away from ocean-facing elevations wherever possible, tucked into protected faces of the structure to limit direct wind and water intrusion
  • Shear walls facing wind and water load are sheeted on both sides rather than one, creating the structural rigidity that coastal wind exposure demands, with additional hold-downs and Simpson ties specified to meet wind zone requirements
  • Pressure treated wood is specified below the flood zone' and roofing and trim materials are selected to perform in a coastal environment rather than simply meeting a standard specification that was written for inland conditions

How does O'Neill Bowes approach site logistics and sequencing on waterfront construction projects?

Waterfront lots on Cape Cod are often the most logistically demanding sites to build on. The constraints don't present themselves mid-project when planning has been done properly in preconstruction.

  • Conservation buffers restrict where equipment can operate, requiring that access routes and staging areas be established in the project plan before construction begins rather than worked out on the fly
  • Tight lot coverage on coastal sites often means there is little room for staging, and sequencing decisions have to account for what phase of work needs what kind of access at each point in the schedule
  • On one recent project, the pool had to be installed early because once the structure was up there was no viable equipment access remaining. The team built their way out, with each completed phase preserving the access needed for the next
  • Phased scheduling tools allow the team to see how sequencing decisions ripple forward through the project before anyone arrives on site, which is where the 2 Cross Tree project's logistics were resolved before ground broke
  • Access routes that work in dry conditions may not work after a storm, and neighbor proximity on tight coastal lots requires construction management that accounts for the scrutiny that waterfront projects tend to attract

What should clients expect from the timeline of a waterfront construction project on Cape Cod?

Timeline expectations are one of the most important things to establish correctly at the start of a waterfront project. The build phase is predictable. What precedes it often is not.

  • The build itself runs nine to eighteen months regardless of square footage, comparable to any custom home of similar scope once the permit is in hand and construction begins
  • Preconstruction and permitting do not run on a builder's schedule, they run on the schedules of the Conservation Commission, the wetlands review process, FEMA flood zone determinations, and town-specific permitting procedures
  • A filing that moves smoothly through one town may sit considerably longer in another, with conditions added and revisions requested that extend the front end of the project beyond what any party anticipated at the outset
  • At OBB, preconstruction is treated as its own phase with its own disciplines and its own timeline management, not as a waiting period before the real work begins
  • Clients who understand the preconstruction timeline going in are better positioned to make good decisions throughout the project, because the surprises that derail waterfront projects almost always originate in the regulatory and planning phase rather than in the construction phase itself
